Wave Propagation Pile Testing Types and Methods

In the 1950’s, E.A. Smith of  the Raymond Pile Driving Company studied wave propagation on slender rods, and developed a numerical analysis method to predict the capacity versus blow count relationship and investigate pile driving stresses.

The model mathematically represents the hammer and all its accessories (ram, cap, cap block), as well as the pile, as a series of lumped masses and springs in a one‐dimensional analysis.

Soil response for each pile segment is modeled as viscoelastic‐plastic.

All components of the system are realistically modeled.

The analysis begins with the hammer ram falling and attaining an initial velocity at impact.

This method is the best technique for predicting the relationship of pile capacity and blow counts (or set per blow), and the only method available to predict driving stresses.

Improvements to Smith’s method to incorporate a thermodynamic diesel hammer model and residual stresses.

The wave equation approach is an excellent predictive tool for analysis of impact pile driving, but it has some limitations.

These are mainly due to uncertainties in quantifying some of the required inputs, such as actual hammer performance and soil parameters.

Types of Wave Propagation Pile Testing

There are different types of Wave Propagation pile testing; three of these tests are covered in this pile testing method statement:

1. High Strain Dynamic Testing

2. Low Strain Pile Integrity Testing

3. Cross Hole Sonic Test

High Strain Dynamic Pile Load Testing

High Stain Dynamic Load Testing (HSDLT) of piles is a fast and effective method of assessing foundation bearing capacity that requires instrumenting a deep foundation with accelerometers and strain transducers and analyzing data collected by these sensors.

The procedure is based on the case method of pile testing and is standardized by ASTM D4945‐08 Standard Test Method for High Strain Dynamic Testing of Piles.

It may be performed on driven piles, drilled piles and other cast in place foundations.

In addition to bearing capacity, Dynamic Load Testing gives information on resistance distribution (pile resistance and end bearing) and evaluates the shape and integrity of  the foundation element.

The foundation bearing capacity results obtained with dynamic load tests correlate well with the results of static load tests performed on the same foundation element.

Frequency of  this test is one pile to represent the entire site including current and future pile installation. Engineer may increase number of piles (Tests) as required. Typically testing includes 5% to 15% of the total number of the working piles.

Prerequisites for High Strain Pile Test

The static axial capacity of piles typically changes as time elapses after pile installation, possibly increasing (setup) or decreasing (relaxation), depending on the soil or rock properties and the pore water pressure and soil structure disturbance induced by installation.

This behavior may affect both driven piles and cast‐in‐place piles. The Engineer may specify a waiting period between pile installation and High Strain Dynamic Load testing to investigate time effects.

The waiting period may range from 3 to 30 days, or longer, based on testing (for example re‐driving piles) or prior experience.

Also the concrete to be sufficiently hardened, which can be confirmed by the concrete test cube reports.

Method of High Strain Dynamic Load testing

High‐strain dynamic testing is performed by obtaining and analyzing records of pile force and velocity under drop weight or Hammer impacts for evaluations of pile load carrying capacity, structural integrity, and load‐movement and pile‐soil load transfer relationships.

Allow sufficient time for driven and cast‐in place deep foundations constructed of concrete to gain adequate structural strength prior to testing.

If a permanent casing is not used as a feature to construct the test pile, then a pile top extension, consisting of a thin walled casing or equivalent, shall be used to extend the test pile. Means to insure flat, level, (axial to test pile) and solid concrete pile top. Concrete should be level with, and slightly above the casing. If the top of the test pile is below grade, then remove surrounding soil so as to completely expose a test area as described above. Windows on at least two opposite sides of the test pile may have to be cut off in the steel casing to reach the concrete. (Not Applicable for a pre‐cast pile or steel Pipe Pile).

In cases where casing is not present, smooth (by grinding) areas around the pile circumference such that proper sensor attachment can be accomplished.

Sensors (at least 2 nos.) shall be attached to the exposed concrete or steel casing in a secure manner as to prevent slippage under impact.

For concrete piles or concrete filled pipe piles, place a pile cushion made of plywood or other material with similar stiffness on top of the pile. For concrete filled pipe piles, the concrete must completely fill the pile top so that the impact is transferred through the pile cushion to the concrete.

Dynamic tests performed during the initial installation of a driven pile typically monitor the performance of  the impact device, the driving stresses in the pile, the pile integrity, and relative changes in capacity. If the test results are used for static capacity computations, then dynamic measurements should (also) be performed during restrikes of  the deep foundation, after waiting a period of  time following the initial installation sufficient to allow pore water pressure and soil strength changes to occur.

A drop weight of approximately two percent (2%) of the anticipated test pile capacity, (one percent may be sufficient for piles with rock sockets); higher percentages are helpful when practical and when available or specialized Diesel/Hydraulic Hammer can be used for pre‐cast piles. The impacting surface of  the drop weight should have an area between 70 and 130% of the test pile top area. The shape of the ram weight should be as regular as possible (square, round, hexagonal, etc.). A top cushion consisting of new sheets of  plywood with total thickness between (50 to 150 mm.) shall be used to absorb the hammer impact.

At least two (2) hammer impacts should be applied to the top of  the pile. First drop height should be minimal to allow the Testing Engineer to assess the testing equipment, the impact system and the stresses on the foundation. Subsequent impacts can then be applied by utilizing sequentially higher drop heights until either stresses in the foundation are excessive or the pile permanent set for the applied impact exceeds 2.5 mm.

Based on the measurements from strain or force, and acceleration, velocity, or displacement transducers, this test method obtains the force and velocity induced in a pile during an axial impact. The Engineer may analyze the acquired data using engineering principles, CAPWAP and judgment to evaluate the integrity of  the pile, the performance of  the impact system, and the maximum compressive and tensile stresses occurring in the pile and after assessing the resulting dynamic soil response along the side and bottom of the pile, the Engineer may analyze the results of a high‐strain dynamic test to estimate the ultimate axial static compression capacity.

High Strain Dynamic Testing Report

The report for Dynamic Load testing shall include the following information:

General Information

Graphical out puts drawing

Detailed Tables outputs

Low Strain Pile Integrity Testing

Low Strain Pile Integrity Test (LSPIT) is echo or seismic method of assessing the integrity of piles, it has been used since the 1970’s to check the integrity of piled foundations and is standardized by ASTM D5882‐07 Standard Test Method for Low Strain Integrity Testing of Piles.

The system measures the velocity response of a pile to a force input generated by a small hammer. The system is rapid in operation and can be used to check the depth of both pre‐cast and cast‐in‐situ piles. The possible causes of intermediate responses can also be assessed.

Frequency of  this test is one pile to represent the entire site including current and future pile installation, client may increase number of  piles (Tests) as required. Typically testing includes 100% of  the total number of  the working piles

Prerequisites for Low Strain Pile Test

For cast‐in‐place concrete piles or concrete filled pipe piles, perform the integrity testing no sooner than 7 days after casting or after concrete strength achieves at least 75 % of  its design strength, whichever occurs earlier.

Ensure that the pile head surface is accessible, above water, and clean of  loose concrete, soil or other foreign materials resulting from construction.

If the pile head is contaminated, remove a sufficient pile section to reach sound concrete.

Because proper pile top preparation is critical to the successful application of  this method, if necessary, prepare small areas by a hand grinder to provide a smooth surface for motion sensor attachment and impact.

Standard Test Method for Low Strain Integrity Testing of Piles

The accelerometer must be firmly affixed to the pile top in order to measure the high‐frequency motion of that surface during impact and reflection. For best results, the accelerometer should be bonded to the pile top. Petroleum  jelly works nicely in cold weather. Other adhesive materials such as plastic clay or bowl sealer wax can also be used.

The motion sensor should be placed at or near the pile head using a suitable, or temporary, thin layer of bonding material (that is, wax, Vaseline, putty etc.) so that it is assured that it correctly measures the axial pile motion (transducer axis of sensitivity aligned with the pile axis).

Motion sensor is placed generally near the center of the pile. Additional locations should be considered for piles with diameters greater than 500 mm.

The low strain impact should be applied to the pile head within a distance of 300 mm from the motion sensor. If the pile head is not accessible, as when already integral with the structure, the sensor(s) may be attached to the side of the pile.

Signals from the motion sensors shall be conveyed to the Pile Integrity Tester (PIT) for recording, reducing, and displaying data as a function of time. The PIT includes a graphic display of velocity, and a data storage capability for retrieving records for further analysis.

Record the measurements from several impacts. Average the suitable records of at least three impacts and apply necessary amplification to the averaged record. The records from the individual impacts or the averaged record, or both, should then be recorded. The averaged, amplified record then can be evaluated for integrity.

Low Strain Pile Integrity Testing Report

The report for Pile Integrity Test shall include the following information:

General Information

Graphical out puts drawing

Detailed Tables outputs

Piles Rating (AA, AB, ABx, PFx or PDx)

Cross Hole Sonic Pile Test Method

Cross‐hole Sonic Logging (CSL) is a NDT method which involves ultrasonic signal transmission through the pile between two parallel water filled access tubes.

The access tubes are often tied to the steel cage and cast permanently into the pile.

Total number of  access tubes typically depends on the diameter of  the pile.

A transmitter probe and a receiver probe are lowered to the bottom of  the pile in separate access tubes.

Measurements of the signal transmission are collected approximately every 5 cm as the probes are raised to the top of  the pile.

The cables attached to the probes are pulled through calibrated encoder wheels which can accurately determine the depth of the probe during testing.

A collection of measurements from one access tube to another are called a profile.

Profiles are collected from all combinations of access tubes.

The test method is described in ASTM D6760‐08.

Frequency of this test is one pile to represent the entire site including current and future pile installation. Engineer may increase number of piles (Tests) as required. Typically testing includes 50% ‐ 100% of the total number of the working piles.

Prerequisites for Cross Hole Sonic Test

The access ducts shall be supplied and installed during construction by or in cooperation with the contractor of  the deep foundation element to be tested. The total number of  installed access ducts in the deep foundation element should be chosen consistent with good coverage of the cross section.

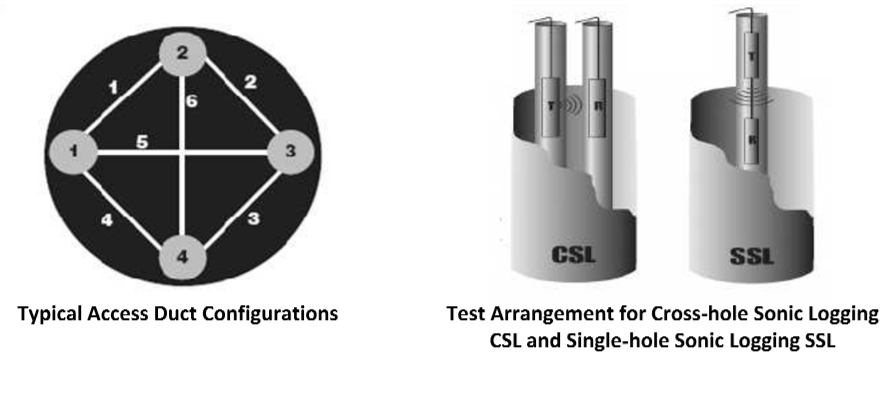

As a guide, the number of access ducts is often selected as one duct for every 0.25 to 0.30 m of deep foundation element diameter, spaced equally around the circumference.

A minimum of three access ducts is preferred for cross hole testing.

Single access tubes of PVC or equivalent other material with low wave speed is acceptable for single hole testing of small diameter deep foundation elements.

Method for Cross Hole Sonic Pile Testing

The actual speed of sound wave propagation in concrete is dependent on the concrete material properties, geometry of the element and wavelength of the sound waves.

When ultrasonic frequencies (for example, >20 000 Hz) are generated, Pressure (P) waves and Shear (S) waves travel though the concrete.

Because S waves are relatively slow, they are of no further interest in this method.

In good quality concrete the P‐wave speed would typically range between 3600 to 4400 m/s.

Poor quality concrete containing defects (for example, soil inclusion, gravel, water, drilling mud, bentonite, voids, contaminated concrete, or excessive segregation of the constituent particles) has a comparatively lower P‐wave speed.

By measuring the transit time of an ultrasonic P‐wave signal between an ultrasonic transmitter and receiver in two parallel water filled access ducts cast into the concrete during construction and spaced at a known distance apart, such anomalies may be detected.

Cross Hole Sonic Test Reporting

The report for Cross‐hole Sonic Test shall include the following information:

General Information

Access Tube Information

Graphical out puts drawing
