Micropile Installation Method Statement

By | July 4, 2025

Below is a precise method statement for micropile construction using the latest technology.

Grout shall be mixed from Ordinary Portland Cement and clean water free from harmful substances.

Usage of other cement which has a higher strength and/or workability shall

also be allowed depending upon the consultant approval.

Grout Mix

The proportions of grout and the minimum strength of work cubes shall comply with the following requirements:

Range of water/cement ratio

Target Resistance to crushing (cube strength)

                 0.42-0.50 (Typically 0.45)

7 days

28 days
21 N/mm2

30 N/mm2

The quantities of cement in the mix shall be measured by weight.

Grout shall be free from segregation, slumping and bleeding.

Grout shall be mixed on site and shall be pumped into its final position as soon as possible.

Non-shrink admixture (SIKA Intraplast-ZTM, also an expansion admixture) shall be added at approximately 1% by weight.

Grout Test

Two sets of three test cubes shall be taken per one grouting operation for testing purpose.

Three test cubes shall be tested at 7 days and the remaining cubes at 28 days after casting.

The characteristic strength of the grout shall be 21 N/mm2 and 30 N/mm2 at 7 days and 28 days. (Note that expansion admixtures may cause a slight decrease in cube strength)

Main Load Bearing Component – Reinforcing Steel

The main steel component and the grout shaft of the micropile shall be designed to support the external loads and bending to be transmitted to/from the load bearing stratum for end-bearing/tension piles, which shall consist of a top anchorage or pilecap (provided by the structural/pilecap contractor) and an axial steel component.

Typical axial steel component consisting of hot rolled deformed high tensile bar with minimum yield stress of 460 N/mm2 or API Pipe.

FABRICATION OF MICROPILE

API Pipes

If API Pipes are used, they shall be joint by either a pipe sleeve (screw-type) or fully butt-welded all around (see installation procedure).

Spacers consist of a small piece of steel plate tag-welded onto the pipe at 3m intervals, each interval in 2 direction or using PVC spacers adhered using epoxy or tie wire.

Reinforcement Bars

The reinforcement of the piles are typically prefabricated on-site or elsewhere and brought to site.

Bars and links are tied together with tie wire to form prefabricated cages.

To join the lengths of the cages, the reinforcement bars shall be lapped 40 times the diameter or 40D.

The joining of the bars (if necessary) shall be done by tie wire or welding.

Spacers used shall be PVC pipes cut into small lengths and tied to the reinforcement bars.

Alternatively, ready-made PVC round spacers can be clipped to the links. A second alternative consist of PVC lantern which is clipped to the main-bars.

Step 1: Check Verticality of Micropile

The pile point is determined by a surveyor and position the drill rig on top of the point.

First drill rod with a drill bit is placed above the drill point.

Ensure verticality is achieved before starting drilling works, this is done by checking the verticality of both the first drill rod and the mast using a spirit level.

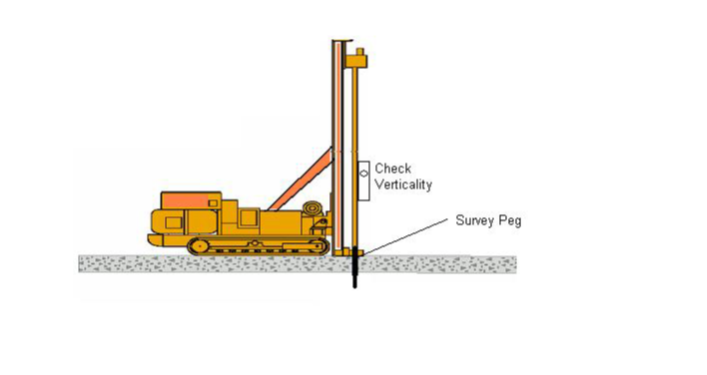

pile point is determined by a surveyor

STEP 2: Wash Boring Method

For drilling in both soft and/or hard soils (typically SPT N>50), the hole can be drilled with the wash boring method using either a drag bit or roller (tricone) bit.

Wash boring, also known as the reverse circulation system is an assembly of a the drill bit, drag bit or roller bit being assembled to the end of a string of drill rods onto a drill rig or drill frame.

The drill bit is advanced by adding drill rods when drilling. Water is pumped through the string of drill rods and the outflow water emerging from the borehole is channeled to a holding pit and recycled through a slurry pump back into the drill rig’s swivel head – hence the term ‘reverse circulation’.

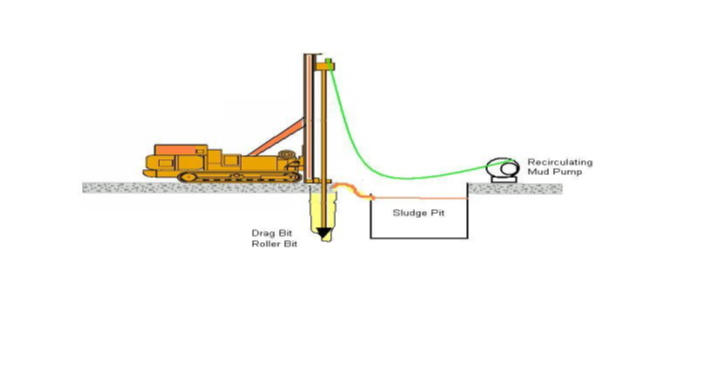

wash boring method for micropile construction

STEP 3 (if required): Drilling Using Temporary Casing

If collapsible soil layers is encountered from step 2, or anticipated from the soil investigation record, drilling using temporary casing shall be employed.

Advance a casing into by either drilling using a casing shoe (by wash boring method) without the aid of a drill rod OR using a drill rod with drag/roller bit together with a casing up to the suspected collapsible layer felt by the driller or soil investigation report.

The latter method can be done without a casing shoe.

Upon reaching the end of the collapsible area (usually sand), cease the advancing of the casing.

Continue drilling using drag/roller bit until the depth of the pile is reached.

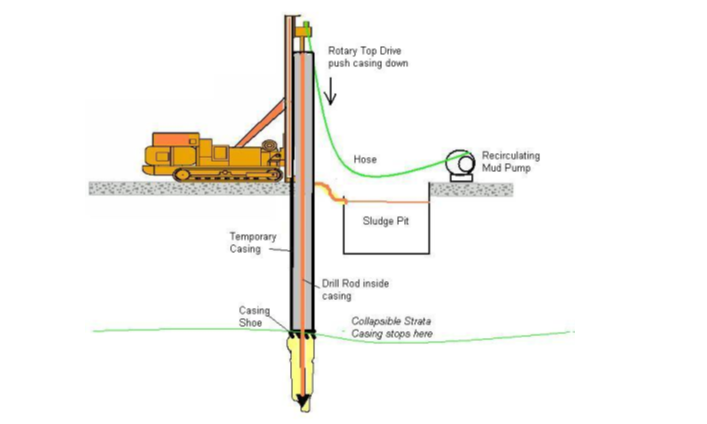

Drilling Using Temporary Casing

Upon completion of the drilling, the borehole is cleaned by flushing out any soil particles from the inside of the casing with recirculation water or air.

STEP 4: API pipes / Reinforcement Bars (Cage) installation

If a mobile crane is to be used for, move the drilling rig back.

The pipe / rebar cage shall be lowered segment-by-segment using a mobile crane.

Cordon the area for safety reasons.

If the drilling rig winch is to be used, lift the pipes/rebar cage up segment-by-segment using the winch. Cordon the area for safety reasons.

The joints of the API Pipe shall be properly screwed together with grease to assist tightening.

If welding is used, clean the edge of the pipe and conduct a full butt weld on the outside of the pipe.

If Reinforcement Bars are used, lap the bar for 40D and join by tie wire or welding.

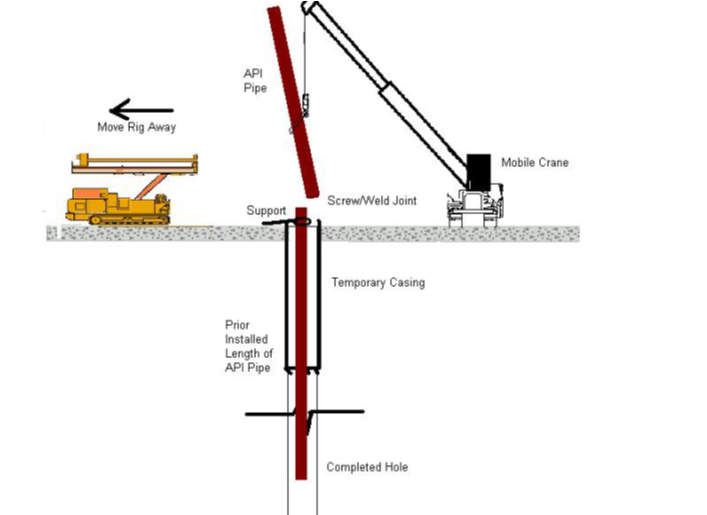

API pipes / Reinforcement Bars (Cage) installation

STEP 5: withdraw the temporary casing

If in  Step 4, the mobile crane is used to install the API Pipes/Rebar Cage, the same mobile crane can be used to pull/withdraw the temporary casing.

Shall this cannot be done due to safety reasons (crane parked too far away), move the drill rig back. Withdraw the casing using the winch tied around the casing.

In case this is not successful, reattach the adaptor and using the reverse circulation method (wash boring), flush water into the casing to loosen it while withdrawing the casing using the rotary unit.

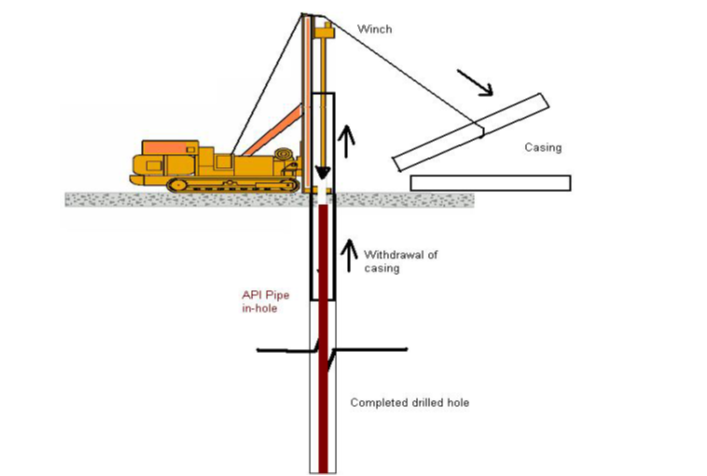

withdraw the temporary casing

STEP 6: Grouting of the micropile by Tremie Method

Mix the cement bag with water in a mixer according to the design mix measurement.

The mixed grout shall be filtered and poured into a holding tank.

Grouting of the micropile is then carried out by Tremie Method using a hose installed right up to the end tip of the pile Rebar assembly cage or API Pipe with flow holes cut at the tip of the API pipe.

Pump the grout into the pile using a piston or diaphragm pump.

Grouting is done until neat grout appears at the top of the borehole.

Upon completion, the grout hose is extracted.

Shall any leftover temporary casing is extracted, or at any time after grouting, the grout level drops below the cut-off level, top-up the hole with grout.

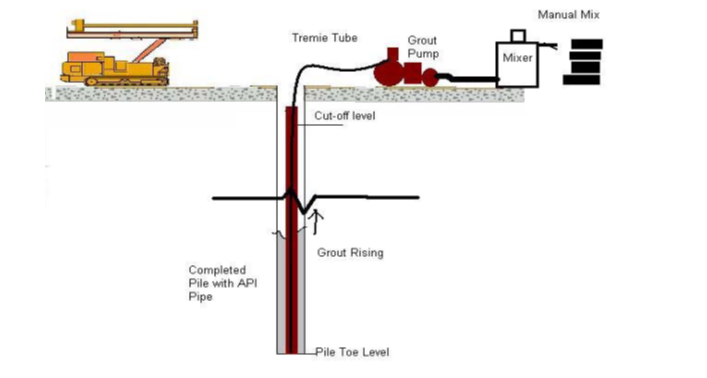

Grouting of the micropile by Tremie Method
